Case Study
Share this
article
Bagley Street Pedestrian
Bridge
-
Michigan's
first cable stayed
footbridge
-
Unique
asymmetric design with asymmetry in two major planes
-
Erection
engineering analysis to develop an erection manual
Detroit’s
Mexicantown Bagley Street Pedestrian Bridge is the first cable-stayed
bridge to be built in the state of Michigan. The bridge was designed
by HNTB Corporation for Michigan Department of Transportation which
appointed URS Corporation to act as its Construction Inspection
engineer. Stress analysis, erection engineering and the preparation of
a detailed erection manual outlining all stages for construction was
carried out by specialist erection engineering consultant Genesis
Structures for its client Walter Toebe Construction using LUSAS Bridge analysis software.
Overview
Constructed as part of the $230 million
I-75 Gateway Project, Bagley Street Pedestrian Bridge is a two-span,
asymmetric cable stayed structure that crosses 10 ramps and roadways,
including both I-75 and I-96, to re-connect the east and west sides of
Detroit’s Mexicantown community which has been divided since I-75
was built in the late 1970s. The bridge has a total length of 417ft
made up of a 276ft main (west) span and a 141ft back (east) span. A
single 155ft tall inclined and tapering concrete and steel pylon
supports the main span via ten forestays set in a fan arrangement. The
back span is fully supported by a deadman abutment and a pylon support
strut. The bridge superstructure comprises a trapezoidal single-cell
steel box girder of constant depth and varying width topped by a
concrete slab that varies from 15ft-3in to 34ft in width over its
length. Concrete barriers cast along the deck stiffen the deck and provide fixity for glazed pedestrian barriers. Five tuned mass
dampers limit any vibrations due to wind or pedestrian traffic.
Staged erection
modelling
Genesis Structures used LUSAS Bridge to
model the bridge’s complex geometry, its members and their
associated material properties . A detailed beam and shell element
model represented all temporary and permanent structural components
and allowed the 62 defined stages of the construction process to be
accurately analysed.
|
Animation
showing erection sequence |
Pylon

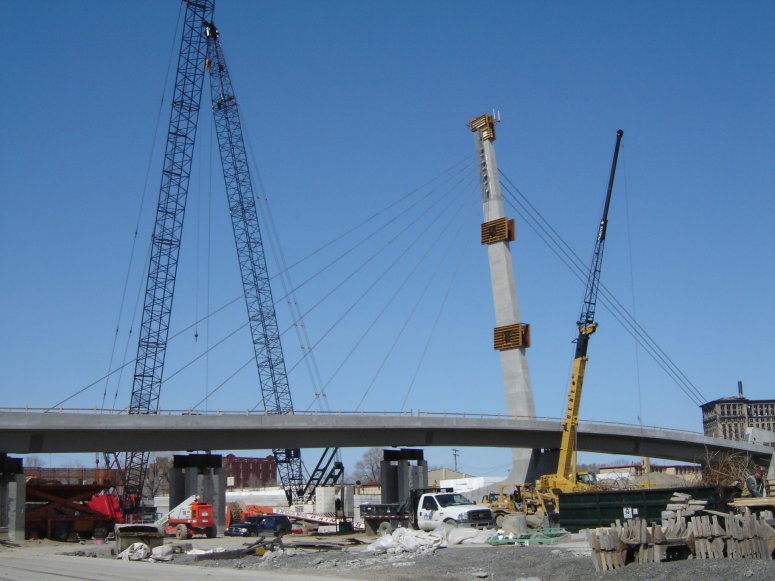

Because
of the unique geometry of the pylon base a separate 3D solid model was
used to fine-tune the base stiffness and beam modelling method used
for the main bridge model. For the main model, section properties for
the pylon itself were obtained from a 3D CAD model. During its construction
the pylon was temporarily restrained using four guy cables at two
vertical levels and in addition to providing support during
construction this also helped maintain alignment and restrict movement
of the pylon prior to the installation of the stay cables and
subsequent post-tensioning of the pylon. Temporary guys, cable load
eccentricities, post-tensioning and time-dependent effects such as
creep and shrinkage to CEB-FIP 1990 were all included and assessed at relevant
stages of the modelling process.
Superstructure and
supports
The steel plates, stiffeners, composite
concrete slab and concrete barriers of the superstructure were all
modeled using 3D shells. Internal girder bracing was modelled with
beam elements. Time-dependent (creep and shrinkage) effects on the
concrete slab were also included. The concrete deck pours required
temporary bearings to be used initially at the abutments (and on the
model) to allow for beam rotation. Then, once the integral abutment
connections were made, the modelled supports were updated accordingly.
The eccentric cable loading on the box girder system produces torsion
and lateral thrust in the girder. This is resisted by upward,
downward, and lateral bearing supports at the abutments and by tension
linkages and vertical and lateral bearings at the pylon support strut.
Three falsework towers that supported the west span were modelled using compression-only supports that allow accurate
modelling of the lift-off behaviour due to cable tensioning.
|
Composite slab
and barrier |
|
Steel box girder
modelling |
Cable installation and
post-tensioning
Cable installation and
stressing were carried out in a balanced manner and to forces defined by
the proposed erection sequence. Some stays required only a
single jacking operation while others required two jacking operations
at different construction stages. As the installation and stressing of
the permanent stays progressed, the temporary pylon guys were removed.
Progressive installation of cables and post-tensioning of the pylon
caused a gradual decrease in reactions and eventual lift-off at the falsework supports. A 30-year creep analysis carried out at
the end of the staged construction process evaluated long-term
effects on the structure.
|
Cable
installation and stressing |
Design
limitations
The contract documentation
placed design limitations on the pylon restricting the horizontal
displacement at its top to two inches and also restricted the maximum amount
of bending moment about its weak axis at a specified level at its base
to be 800 kip ft during its construction, unless any exceeded values
could be proved safe. John Boschert, Structural Engineer at Genesis
Structures explains: "The aim of limiting these values was
to minimize
the creep and shrinkage effect and achieve better geometry control."
He continues, "By carrying out a detailed LUSAS analysis
of the pylon at all stages of construction we were able to show that the effect
on creep from the actual pylon deflection was acceptable, and that the
overall moment capacity about the weak axis of the pylon was
sufficient to resist the actual bending moments seen during
construction."
Results
obtained
From the analysis
carried out with LUSAS, numerous graphs and diagrams were created to
show time-history effects for key components of the structure. These
included:
-
Displacement time-history
for the top of pylon
-
Bending moment diagrams for
the pylon weak axis during construction
-
Cable tension
time-histories for the temporary and permanent cables
-
Reaction time-histories
for all abutments, bearings and falsework supports
-
Vertical displacement and
stress plots for the top and bottom of the steel box for
all stages of construction and for the beginning and end of service
conditions
Beginning and end of service
stresses for the cable stays and beginning of service
stresses in the concrete deck slab were also
obtained. Representative graphs produced
from the results of LUSAS analyses are shown below:
|
Representative time-history graphs produced
from LUSAS analyses
|
|
Bending moment
in pylon for a specific construction stage
|
|
Vertical
displacement in top and bottom of steel box girder for a
specific construction stage
|
|
Longitudinal
stress in steel box girder for a specific construction stage
|
Summary
From the staged
erection analysis carried out with LUSAS Bridge, Genesis Structures
was able
to simulate and prove the proposed erection sequence and prepare a detailed erection manual and associated geometric control
plan for its client and general contractor Walter Toebe Construction.
Three-dimensional target coordinates and elevations were provided for key points on the
structure, including at the pylon stay housing, at temporary shoring,
at box girder splices, along the box girder deck and at all stay cable
connection points.
For more
details on this
project see Modern
Steel Construction magazine July 2010.
"Modelling each
stage of construction in LUSAS facilitated accurate geometry control
and allowed us to confidently monitor the pylon bending demands."
John
Boschert,
Structural Engineer, Genesis Structures
